How to keep your kitchen renovation on schedule

How to Keep a Kitchen Remodel on Schedule

Kitchen Remodel Planning

To keep a kitchen remodel on schedule, finalize the design before construction, order critical materials early, confirm permits and inspections, and sequence each trade around verified delivery dates rather than estimated availability.

A workable schedule is not simply a proposed completion date. It is a chain of connected decisions covering demolition, rough plumbing and electrical work, inspections, drywall, cabinets, countertop templating, finishes, and appliance installation. One unresolved selection or late delivery can prevent several later tasks from starting.

Schedule essentials: Complete major design decisions before demolition and confirm that cabinets, fixtures, appliances, and finish materials are available when needed. Build the construction sequence around dependencies rather than scheduling every trade at once. Document approvals, substitutions, change orders, and inspection responsibilities so that decisions do not remain unresolved. Review progress regularly against the next required milestone, not only against the final completion target.

What Actually Keeps a Kitchen Remodel on Schedule?

The strongest protection against delays is completing the planning work before the kitchen becomes unusable. The floor plan, cabinet dimensions, appliance specifications, lighting locations, plumbing positions, finish selections, and scope of demolition should be coordinated before crews begin opening walls. A detailed kitchen remodel checklist helps expose missing decisions while they can still be corrected without disrupting active construction.

The schedule should identify more than broad phases. It should show which activity must be completed, inspected, measured, delivered, or approved before the next activity begins. Countertops cannot be accurately templated before base cabinets are installed and verified. Cabinet installation may stop if flooring, wall preparation, electrical boxes, or plumbing connections conflict with the approved layout.

Three areas have the greatest influence on day-to-day progress:

Design Decisions

Cabinet configuration, appliance models, sink location, lighting, hardware, tile, and finish transitions should be resolved before their dimensions affect framing or utility work.

Material Readiness

Cabinets, fixtures, specialty hardware, appliances, and finish materials should have confirmed availability, delivery conditions, and storage plans before dependent work is scheduled.

Trade Sequencing

Demolition, rough utilities, inspections, wall repair, flooring, cabinetry, countertops, tile, painting, and final connections must follow a coordinated order.

Contractors coordinating sequential stages of a kitchen remodeling project
A reliable schedule links each trade to the completed work, measurements, and approvals it needs.

Finish the Design Before Demolition Begins

Demolition should not serve as the beginning of the design process. Once walls, cabinets, and utilities are exposed, unresolved choices can become urgent field decisions. Those decisions are more likely to trigger revised drawings, changed material orders, relocated outlets, altered plumbing, or additional patching.

Before work starts, confirm the cabinet plan against the actual room dimensions and the specifications of the refrigerator, range, hood, dishwasher, sink, and built-in accessories. Door swings, filler panels, countertop overhangs, appliance ventilation, and access to shutoffs should also be coordinated. A seemingly minor appliance substitution can affect cabinet openings, electrical requirements, plumbing connections, and countertop fabrication.

Structural changes, relocated utilities, enlarged openings, and other work subject to local review may require permits or inspections. Requirements depend on the property, jurisdiction, and project scope, so responsibility for drawings, submittals, corrections, inspection requests, and approved documents should be assigned before construction. Permit uncertainty should not be hidden inside an optimistic start date.

Decisions to Lock Early

Cabinet dimensions, appliance models, plumbing fixtures, lighting locations, flooring transitions, countertop edges, tile layout, and hardware should be approved before they control field measurements or rough-in positions.

Decisions That May Stay Flexible

Decorative accessories and movable furnishings can often remain open longer, provided they do not affect electrical boxes, blocking, cabinet clearances, finished dimensions, or ordered materials.

Order Materials Around Construction Dependencies

Early ordering does not mean purchasing every item immediately. It means identifying which items can stop construction if they arrive late, damaged, incomplete, or in the wrong size. Cabinets, specialty fixtures, appliances with fixed openings, custom glass, tile requiring a specific layout, and proprietary hardware usually deserve closer tracking than easily substituted decorative items.

Each critical order should have a written model number, finish, quantity, estimated delivery window, receiving location, and inspection plan. Delivery confirmation should distinguish between an item being manufactured, shipped, delivered to a warehouse, and physically available for installation. Those are different milestones.

Materials also need secure storage and inspection. Opening cartons early enough to identify visible damage, missing components, or incorrect finishes can prevent the discovery from occurring on installation day. For projects managed through professional kitchen remodeling, ask how procurement status is tracked and who is responsible for replacement orders.

Practical note: A shipping estimate is not an installation date. Schedule dependent work only after the required item, correct specifications, site conditions, and installer availability have been verified.

Sequence the Work by Prerequisites, Not Convenience

A kitchen renovation has a logical workflow, but the exact order can vary with the scope, flooring strategy, structural work, and inspection requirements. The schedule should therefore show prerequisites rather than relying on a generic sequence copied from another project.

Demolition may reveal previous repairs, damaged framing, uneven surfaces, outdated connections, or utilities that do not match the proposed layout. These conditions may require assessment before walls are closed or cabinets are installed. The schedule should include a decision point after demolition so discovered conditions can be documented, priced, and approved without creating confusion.

Schedule DecisionWhy It MattersWhat to Verify
Start demolitionThe kitchen becomes unavailable and concealed conditions are exposed.Approved scope, material readiness, protection plan, and disposal access
Begin rough utilitiesPlumbing and electrical locations depend on the final cabinet and appliance plan.Current drawings, product specifications, and field dimensions
Close wallsConcealed work may need inspection or documentation before covering.Required approvals, blocking, utilities, and corrected deficiencies
Install cabinetsCabinet position controls countertop measurements and appliance clearances.Level surfaces, finished floor strategy, fillers, panels, and delivered parts
Template countertopsAccurate fabrication depends on fixed cabinets, sinks, and appliance openings.Final cabinet placement, sink model, edge detail, and seam decisions
Complete finishesTile, paint, trim, fixtures, and final connections can interfere if poorly ordered.Curing needs, access, protection, and remaining correction work
Kitchen renovation plan showing ordered construction tasks and checkpoints
Each milestone should identify the required decision, completed work, and responsible party.

Coordinate Contractors, Trades, and Inspections

A schedule can fail even when every individual trade performs well. The problem usually appears at the handoff between trades: framing is not ready for electrical work, inspection has not been requested, drywall covers missing blocking, cabinets arrive before the room is prepared, or an appliance connection differs from the approved specification.

One person should control the master schedule and confirm readiness before calling the next trade. Homeowners should establish this responsibility while reviewing questions for a kitchen contractor. Without a named coordinator, each installer may assume someone else has verified the preceding work.

Progress meetings do not need to be lengthy, but they should resolve concrete issues. Review what was completed, what remains open, which decisions are due, which materials are physically available, whether inspections are needed, and what must happen before the next crew arrives.

Questions to Confirm Before Each Major Phase

  • Has the preceding work been completed, checked, and documented?
  • Are the latest drawings and product specifications available on site?
  • Are all required materials present, correct, and undamaged?
  • Does an inspection or approval need to occur before work is covered?
  • Who will resolve field conflicts and authorize any scope change?

Control Change Orders Before They Disrupt the Workflow

Changes are not automatically a sign of poor management. Concealed conditions, discontinued materials, field dimensions, or revised homeowner priorities can legitimately alter the work. Delays become more likely when a change is discussed informally but not converted into an approved decision with clear effects on materials, labor, inspections, and dependent tasks.

A written change order should identify the revised scope, affected selections, responsibility for ordering, and schedule consequences before related work proceeds. The purpose is not paperwork for its own sake. It prevents one trade from building to the original plan while another follows a verbal revision.

Reviewing methods for preventing avoidable change orders can help distinguish necessary field adjustments from changes caused by incomplete selections. When a substitution is proposed, compare dimensions and installation requirements, not only appearance.

What Affects the Cost of Keeping the Project Moving?

Schedule control and cost control are closely connected. Expedited shipping, repeated trade visits, remobilization, temporary protection, storage, revised fabrication, and corrective work can increase the scope even when the original design remains unchanged. Delayed decisions may also reduce the number of practical alternatives available.

A realistic budget should separate planned work from uncertain conditions that cannot be fully evaluated before demolition. Cost expectations should also account for coordination tasks, permit-related work where applicable, material handling, and corrections discovered during inspections or installation.

  • Custom cabinet fabrication and replacement of damaged components
  • Relocation of plumbing, electrical, ventilation, or appliance connections
  • Structural or surface repairs revealed after demolition
  • Restricted access, limited storage, or difficult material delivery
  • Expedited orders, repeated site visits, and revised fabrication

Clear allowances, selection deadlines, and approval procedures also support better control of remodeling costs. A lower initial allowance can create both budget pressure and schedule disruption if the selected product cannot be sourced within that allowance or delivery window.

Common Scheduling Mistakes That Create Kitchen Delays

Starting demolition before critical selections are complete creates urgency around decisions that should have been resolved during design. Cabinet openings, appliance specifications, plumbing fixtures, lighting, and finish transitions can all affect rough work.

Treating estimated delivery as confirmed availability leads to crews being scheduled around materials that are still in transit, incomplete, damaged, or stored somewhere other than the project site.

Booking trades without readiness checks can produce repeated mobilization. An installer may arrive and find that inspection is incomplete, dimensions have changed, surfaces are not ready, or a required component is missing.

Making verbal changes without updated documentation allows different people to work from different instructions. Drawings, selections, and written approvals should reflect the current decision.

Compressing finishing work into the final days leaves no room for adjustments, damaged-part replacement, paint touch-ups, hardware alignment, appliance testing, or correction of incomplete items.

When Professional Review Is Necessary

Homeowners can safely track selections, deliveries, written approvals, visible progress, and unresolved punch-list items. They should not attempt to evaluate concealed electrical work, plumbing connections, structural alterations, ventilation performance, or code compliance solely by appearance.

Professional assessment may be required when demolition reveals damaged framing, moisture, previous unpermitted alterations, conflicting utilities, or conditions that differ materially from the drawings. Cosmetic work should pause when proceeding would conceal the condition or make later correction more difficult.

The responsible contractor or qualified design professional should also confirm whether a proposed change affects permits, inspections, structural details, energy requirements, or approved plans. Requirements can vary by jurisdiction and project scope, including within Los Angeles County.

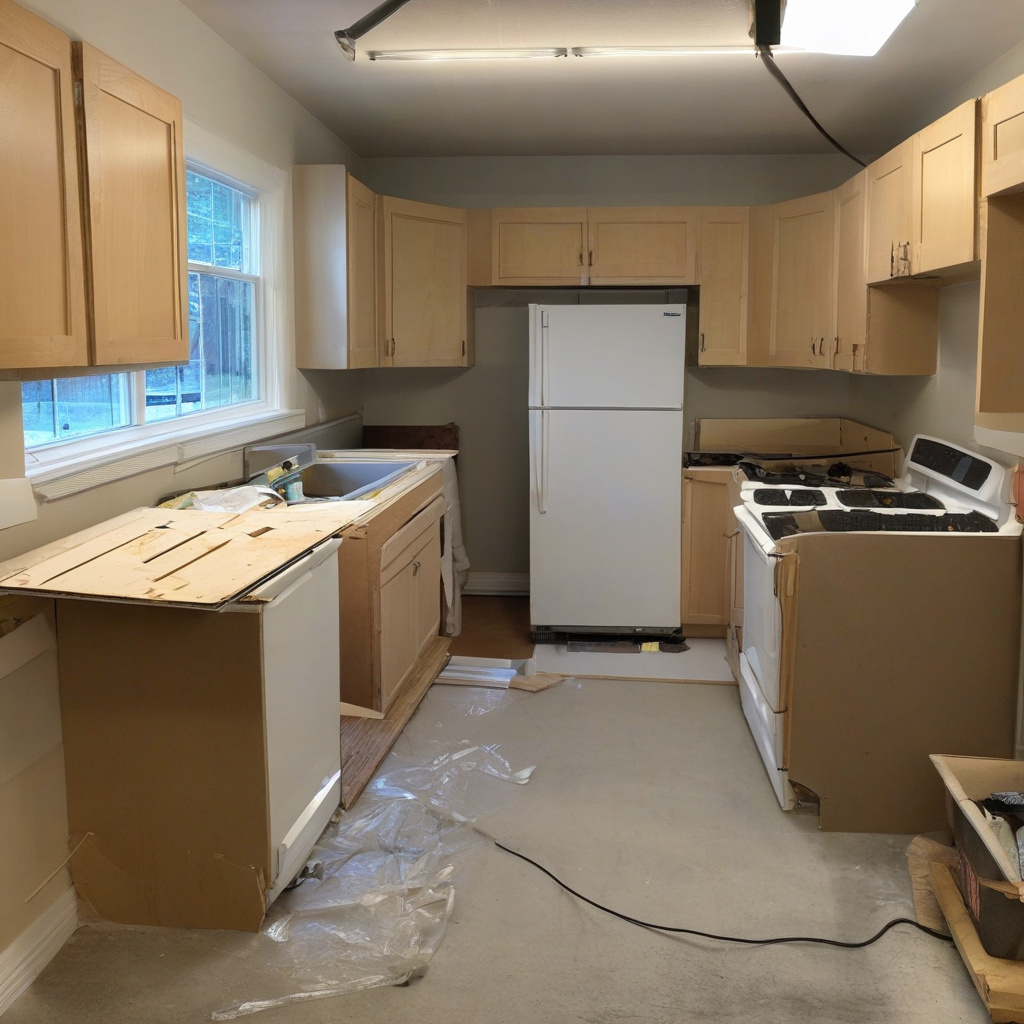

Completed kitchen undergoing final cabinet and appliance inspection
Closeout should verify operation, alignment, finish quality, documentation, and remaining corrections.

Close Out the Remodel Without Rushing the Final Checks

A project is not complete simply because the kitchen looks finished. Final review should cover cabinet doors and drawers, hardware alignment, countertop seams, caulk joints, tile transitions, paint repairs, plumbing fixtures, lighting controls, ventilation, appliance fit, and visible damage to completed surfaces.

Create one consolidated punch list rather than sending scattered requests to different trades. Assign responsibility, record the required correction, and confirm whether access, replacement parts, curing, or another inspection is needed. This keeps closeout work from being mistaken for an unexplained schedule overrun.

Collect relevant permits, inspection records, product documentation, care instructions, warranties, and approved change orders before final closeout. The final schedule milestone should be completion of agreed corrections and documentation, not merely the last day a crew is expected on site.

  • Finalize the kitchen design and critical orders before demolition.
  • Build the schedule around verified prerequisites and material availability.
  • Do not schedule trades from unconfirmed shipping estimates.
  • Seek professional review when concealed damage or utility conflicts appear.
  • Track the next milestone, responsible person, and unresolved decision in writing.

Frequently Asked Questions

When should kitchen materials be ordered?

Critical products should be ordered after their dimensions, finishes, specifications, and compatibility with the design have been confirmed. Cabinets, appliances, plumbing fixtures, specialty hardware, and materials that control later measurements deserve priority. Before demolition, verify not only an estimated ship date but also where the product will be received, inspected, stored, and made available to the installer.

Should demolition wait until cabinets arrive?

That decision depends on the project scope, available storage, cabinet status, and the work required before installation. At minimum, the cabinet order, specifications, delivery plan, and likely installation window should be confirmed. Beginning demolition while a critical order remains uncertain can leave the kitchen unusable with no reliable path to the next major construction milestone.

What usually causes gaps between kitchen trades?

Gaps often occur when the next trade is scheduled before the site is ready. Common triggers include incomplete inspections, missing materials, unresolved dimensions, unapproved changes, unfinished surface preparation, or work that failed a readiness check. A coordinator should confirm prerequisites several days before each handoff and immediately reschedule dependent tasks when a milestone has not been completed.

Can homeowners make design changes during construction?

Changes can be made, but their effects should be evaluated before related work continues. A revised appliance, sink, cabinet, tile layout, or lighting plan may affect rough utilities, ordered materials, fabrication, permits, and completed surfaces. The change should be documented with its scope, responsibility, cost implications, and schedule impact so every trade works from the same current instructions.

How often should the kitchen remodel schedule be reviewed?

The schedule should be reviewed whenever a major milestone is completed, delayed, inspected, or changed. Regular reviews are useful only when they focus on actionable information: current progress, missing decisions, delivery status, inspection needs, and readiness for the next trade. A static calendar that is not updated after field changes provides little protection against later conflicts.

Do permits affect a kitchen renovation timeline?

Permits and inspections may affect the schedule when the project includes work subject to local review. The applicable requirements depend on the jurisdiction, property, and scope, so they should be confirmed for the specific project. Identify who prepares documents, submits revisions, requests inspections, keeps approved plans available, and resolves corrections before assigning construction dates that depend on approval.

How can appliance substitutions delay a remodel?

A substitute appliance may have different opening dimensions, door clearances, electrical service, plumbing connections, ventilation requirements, or panel details. Those differences can affect cabinets, countertops, rough utilities, and nearby finishes. Before approving a substitute, compare the complete installation specifications with the current design rather than relying on the product category or exterior dimensions alone.

What should be checked before final payment?

Review the agreed scope, approved changes, punch-list corrections, visible finishes, cabinet operation, fixtures, lighting, ventilation, appliances, and required project documentation. Confirm that incomplete items are clearly assigned and that necessary inspections or approvals have been addressed. Final acceptance should follow the contract and verified completion rather than the appearance of a mostly finished kitchen.
