Bathroom Remodeling Costs
The cost to relocate a toilet, tub, or shower depends mainly on the new drain route, venting method, floor structure, access to existing pipes, waterproofing scope, and the repairs required after plumbing work is complete.
Moving a fixture a short distance is not automatically inexpensive. A nearby location can still require concrete cutting, joist modifications, a new vent path, wall demolition, or reconstruction of the entire wet area. The most reliable estimate comes from a layout reviewed against actual framing and plumbing conditions.
Cost overview: Toilet moves are often sensitive to drain size, elevation, and connection location. Tub and shower relocations add trap, vent, waterproofing, slope, and finished-surface requirements. Slab-on-grade homes can require concrete cutting and restoration, while raised foundations may provide better access but introduce framing conflicts. Compare proposals by complete scope rather than by a single plumbing allowance.
What Makes Bathroom Plumbing Relocation Expensive?
Bathroom fixture relocation becomes expensive when the new layout changes concealed systems rather than only visible finishes. The plumber may need to reroute drainage, provide an approved vent connection, extend hot and cold water lines, coordinate fixture supports, and reconnect the work to existing piping that was not visible during design.
The drain route usually has the greatest influence. Waste piping must maintain the required size, direction, slope, venting, and connection conditions for the fixture and building. A layout that looks efficient on a floor plan may be difficult to construct if a beam, footing, post-tensioned slab, low crawlspace, or existing utility occupies the intended route.
Planning plumbing moves during a bathroom remodel before demolition allows the contractor to compare the desired layout with less invasive alternatives. Moving a vanity may be relatively manageable, while relocating a toilet or curbless shower across the room can change the entire below-floor plumbing strategy.
Toilet Relocation
A toilet requires a comparatively large waste connection, dependable venting, correct flange elevation, secure mounting, and adequate clearance in the finished layout.
Shower Relocation
A shower move affects the trap, drain location, floor slope, waterproofing system, curb or recess design, valve piping, and surrounding tile work.
Tub Relocation
A tub move requires coordinated drain and overflow connections, water supplies, fixture support, access where required, and repairs around the new footprint.

Moving a Toilet Usually Creates the Most Drainage Constraints

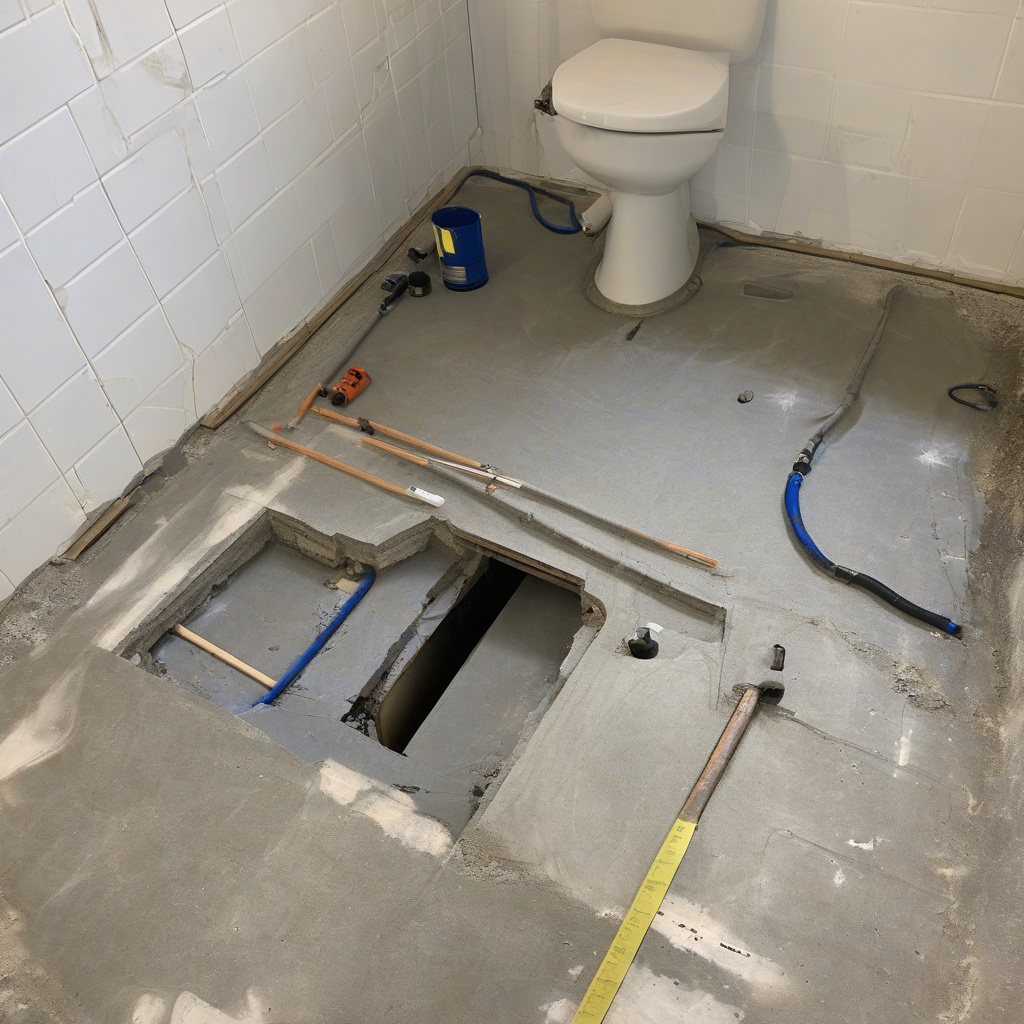

A toilet cannot be treated like a sink that can be shifted wherever a wall has space. Its waste line must connect to the sanitary drainage system using an approved route, and the finished flange must align correctly with the floor and fixture. Extending the route may require opening a slab, removing subfloor, working between joists, or altering nearby branch piping.
Moving the toilet within the same joist bay or toward an accessible drain connection may reduce disruption. Moving across structural framing, away from the main branch, or to an area with limited vertical clearance can require a more complex design. Framing should not be cut or drilled beyond permitted limits simply to create a convenient pipe path.
The new location must also preserve usable clearances, door movement, access to the shower or tub, and a practical relationship to the vanity. A layout that technically fits on paper may feel cramped after wall finishes, tile, baseboards, and fixture projections are included.
A Short Move May Be Practical
The new toilet remains near the existing waste branch, the floor structure provides a clear route, and the vent and flange can be installed without major reconstruction.
A Short Move May Still Be Costly
A footing, beam, slab reinforcement, low crawlspace, or conflicting pipe can turn a small dimensional change into extensive demolition and repair.

Slab, Crawlspace, and Framed Floors Change the Scope
In a slab-on-grade home, relocating a drain may require identifying the existing pipe route, scanning or otherwise evaluating the slab where appropriate, cutting concrete, excavating, installing and testing the new piping, then restoring the fill and slab. The finish floor and waterproofing cannot be rebuilt until the concealed work has passed the required inspections.
Raised foundations and crawlspaces may offer direct access, but they are not automatically simple. Limited working height, damaged framing, inaccessible connections, inadequate pipe elevation, or beams running across the desired route can increase labor. Finished ceilings below an upstairs bathroom add another layer of demolition and repair.
Post-tensioned slabs and structural components require particular caution. Contractors should not cut, core, or trench a structural element without determining what is present and obtaining the appropriate professional direction. The final route may need to change when the intended path conflicts with reinforcement or supporting construction.
Practical note: The shortest line between the old and new fixture locations is not always the correct plumbing route. Drainage elevation, venting, framing, reinforcement, and connection access can make a longer route safer and more practical.
Drain, Vent, Supply, and Waterproofing Work Must Be Priced Together
A plumbing relocation estimate should identify more than the new drain. Each trapped fixture needs an approved drainage and venting arrangement, and the permissible configuration depends on the fixture, pipe sizes, developed lengths, fittings, and connections in the existing system. These details should be determined by the plumbing professional and verified through the applicable permit process.
Water-supply changes are usually less invasive than large drain moves, but they still affect walls, valves, fixture supports, testing, insulation where required, and finish repairs. Shower controls, body sprays, tub fillers, hand showers, and wall-mounted fixtures may also require blocking and precise rough-in dimensions.
Moving a tub or shower changes the wet-area construction. The new receptor, drain, curb, walls, niches, benches, and penetrations must integrate with one continuous waterproofing strategy. A relocated drain cannot be evaluated separately from the floor slope and waterproofing system around it.
| Cost Factor | Why It Changes the Scope | What to Clarify |
|---|---|---|
| Drain distance and elevation | The pipe needs a compliant route to an appropriate connection. | Proposed route, pipe access, and connection point |
| Vent configuration | The new fixture location may not work with the existing vent arrangement. | New vent path, approved alternative, and roof or wall repairs |
| Floor construction | Concrete, joists, beams, and crawlspace access require different methods. | Scanning, demolition, structural limits, and restoration |
| Wet-area reconstruction | Shower and tub moves affect waterproofing, slope, backer, and tile. | Complete waterproofing system and responsibility for testing |
| Existing pipe condition | Corrosion, damage, or unsuitable prior work may expand the repair area. | Replacement limits and approval process for added work |
| Permit and inspection sequence | Concealed work may need approval before floors and walls are closed. | Permit responsibility, inspection stages, and correction work |

Permits and Inspections Affect Both Cost and Sequence
Relocating bathroom drainage, vents, or water piping generally involves permitted plumbing work. The exact permits, documents, and inspections depend on the jurisdiction and total remodel scope. Los Angeles projects may also combine plumbing review with building, electrical, or mechanical work when walls, framing, lighting, ventilation, or structural elements are changed.
The concealed plumbing should remain accessible until the required inspection has occurred. Closing a trench, floor cavity, or wall before approval can create additional removal and repair. The contractor should identify who obtains the permit, requests inspections, provides approved plans, and corrects any work that does not pass.
California requires contractors performing regulated plumbing work to hold the appropriate license or use properly licensed subcontractors. Homeowners should verify the responsible trade and make sure the scope appears in the written agreement rather than relying on an informal allowance.
Before signing, use contract questions for fixture relocation to establish how permits, concealed conditions, exclusions, inspections, material changes, and finish restoration will be handled.
What to Request Before Approving the Plumbing Move
- A dimensioned bathroom layout showing the old and proposed fixture locations
- A description of the expected drain, vent, and water-supply routes
- Clear allowances for demolition, slab or framing access, and finish repairs
- Responsibility for permits, inspections, testing, waterproofing, and corrections
- A written process for pricing concealed damage or required scope changes
What Affects the Cost to Relocate a Toilet, Tub, or Shower?
The total should be divided into plumbing work, access, reconstruction, and uncertainty. A proposal that lists only labor and pipe does not show the cost of opening the building or restoring it after inspection. The same fixture move can have a very different total scope in a slab bathroom, an upstairs bathroom, and a room over an accessible crawlspace.
Toilet relocation may require extensive drainage work but limited wall waterproofing. A shower move may use a smaller drain while requiring a new receptor, waterproofing, tile, glass coordination, valve piping, and floor transitions. A tub relocation adds fixture handling, support, drain-and-overflow access, filler connections, and repairs around a larger footprint.
Existing conditions are another major variable. Demolition may reveal deteriorated piping, previous unpermitted changes, water damage, inadequate framing, or connections that cannot support the proposed layout. These conditions should be documented before extra work begins through the written process for plumbing-related change orders.
- Distance from the new fixture to a usable drain and vent connection
- Concrete cutting, excavation, crawlspace access, or ceiling demolition
- Structural review and framing modifications around the pipe route
- Waterproofing, shower-pan construction, tile, flooring, and drywall repairs
- Permits, inspections, testing, debris removal, and temporary fixture loss

When Is Relocating a Bathroom Fixture Worth the Cost?
Relocation is easier to justify when it solves a specific functional problem that cannot be corrected by changing fixture size, door swing, storage, or finish selection. Useful improvements may include creating a workable shower, providing safer circulation, separating the toilet from the entry view, or making space for a vanity that serves the household properly.
The value is less clear when a fixture is moved only to create a minor visual difference while the existing plumbing locations already support a functional layout. Keeping the toilet, tub, or shower near its current drain can preserve more of the budget for waterproofing, ventilation, storage, lighting, and durable finishes.
Ask the designer or contractor to prepare at least one layout that retains major plumbing locations. Comparing that option with the fully relocated plan reveals what the additional plumbing work actually achieves. It can also identify a partial move that improves circulation without crossing structural framing or trenching a large area of slab.
A complete bathroom plumbing relocation proposal should connect the cost to a measurable layout improvement, not simply describe the move as an upgrade.
Common Mistakes That Increase Plumbing Relocation Costs
Finalizing the layout before checking the drain route can leave the homeowner committed to a design that conflicts with framing, slab reinforcement, or available pipe elevation.
Pricing only the plumber’s portion excludes demolition, concrete repair, carpentry, waterproofing, tile, drywall, painting, and flooring required to complete the room.
Moving the shower drain without redesigning the wet area ignores floor slope, curb height, waterproofing transitions, glass placement, and the finished relationship to the bathroom floor.
Assuming existing pipes can be reused may create a budget gap when demolition reveals corrosion, damage, unsuitable materials, or prior work that must be corrected.
Allowing unapproved structural cutting can turn a plumbing issue into a framing repair. Pipe convenience does not override limits on drilling, notching, or altering structural components.
Ordering fixtures before rough-in review may create conflicts with drain locations, valve depths, overflow assemblies, supports, wall thicknesses, or required clearances.

How Plumbing Relocation Changes the Remodel Timeline
Fixture relocation adds steps before finish installation can begin. The work may include demolition, investigation, layout verification, trenching or floor access, rough plumbing, testing, inspection, concrete or framing repair, waterproofing, and curing before tile and fixtures are installed.
Schedule risk increases when the new route cannot be confirmed until demolition. It also increases when special fixtures have incomplete specifications, inspection corrections are required, or damaged existing piping expands the scope. The contractor should identify decision points rather than promising that every concealed condition has already been priced.
Materials should not cover plumbing that still requires inspection or testing. Cabinet installation, shower glass measurement, tile layout, and final fixture setting may all depend on the completed rough-in dimensions. Guidance on plumbing work within the bathroom timeline can help homeowners understand these dependencies.
Before construction begins, confirm which bathroom facilities will remain available and when water service may be interrupted. A technically minor relocation can create substantial household disruption if it affects the only bathroom in the home.
- Plumbing relocation cost is driven mainly by the concealed drain and vent route.
- Floor construction and access matter more than fixture-to-fixture distance alone.
- Do not compare estimates that omit waterproofing and finish reconstruction.
- Professional review is required when pipes conflict with structural construction.
- Compare a relocated layout with an option that keeps major drains in place.
Frequently Asked Questions
Which bathroom fixture is usually hardest to relocate?
A toilet often creates the greatest drainage constraints because its waste connection is larger and must reach a suitable branch with the correct routing and elevation. Difficulty still depends on the building. A shower move across a structural slab or a tub move requiring extensive waterproofing and wall reconstruction may create a larger total scope than a nearby toilet relocation.
Can a toilet be moved without opening the floor?
Usually some form of access is needed to change the waste connection. The work might occur through a crawlspace, from a ceiling below, within an opened framed floor, or through a concrete slab. The appropriate route depends on the existing plumbing and structure. Surface-mounted shortcuts should not be assumed acceptable without confirmation from the plumbing professional and building department.
Why does moving a shower drain increase remodeling cost?
The drain must connect to an approved trap, vent, and sanitary branch, but the work extends beyond piping. The shower floor must drain correctly, and the receptor, curb or recess, waterproofing, wall board, tile, and glass layout must fit the new location. Moving the drain can therefore require reconstruction of most or all of the wet area.
Is plumbing relocation cheaper over a crawlspace?
Crawlspace access can reduce concrete demolition, but it does not guarantee a simple relocation. Low clearance, beams, foundations, existing utilities, damaged framing, and insufficient drainage elevation may complicate the route. The contractor should inspect the actual space and connection points before treating raised-floor construction as a predictable cost advantage.
Do I need a permit to move bathroom plumbing?
Relocating drains, vents, and water piping generally involves permitted plumbing work, although the exact process depends on the jurisdiction and total project scope. Structural, electrical, mechanical, or building permits may also apply when related systems are changed. Confirm requirements with the local building department and identify permit responsibility in the written contract before work begins.
Can the old shower or tub drain be reused?
It may be reusable when its location, size, condition, trap, venting, and connection suit the new fixture and approved design. Reuse should not be assumed before inspection. Corrosion, damage, inaccessible fittings, poor prior work, or an incompatible drain position may require partial replacement even when the new fixture remains close to the original location.
How can I reduce the cost of moving bathroom fixtures?
Keep major drains near accessible existing connections, compare layouts before demolition, and avoid crossing beams or trenching large slab areas when another arrangement works. Select fixtures early enough to coordinate rough dimensions, and request proposals that include demolition and restoration. Saving on the pipe route while creating expensive waterproofing or structural work does not reduce the total project cost.
What should a plumbing relocation estimate include?
The estimate should identify demolition, access, drain and vent work, water supplies, permits, inspections, testing, slab or framing restoration, waterproofing, tile, drywall, flooring, fixture installation, debris removal, and exclusions. It should also explain how concealed damage and route changes will be approved. A single plumbing allowance is not enough to compare complete bathroom remodeling proposals.
